Current as of October 7, 2026. This story is moving. Oracle's stock, its bond prices and the permits in New Mexico can change week to week, so some numbers here may have changed since it was written.

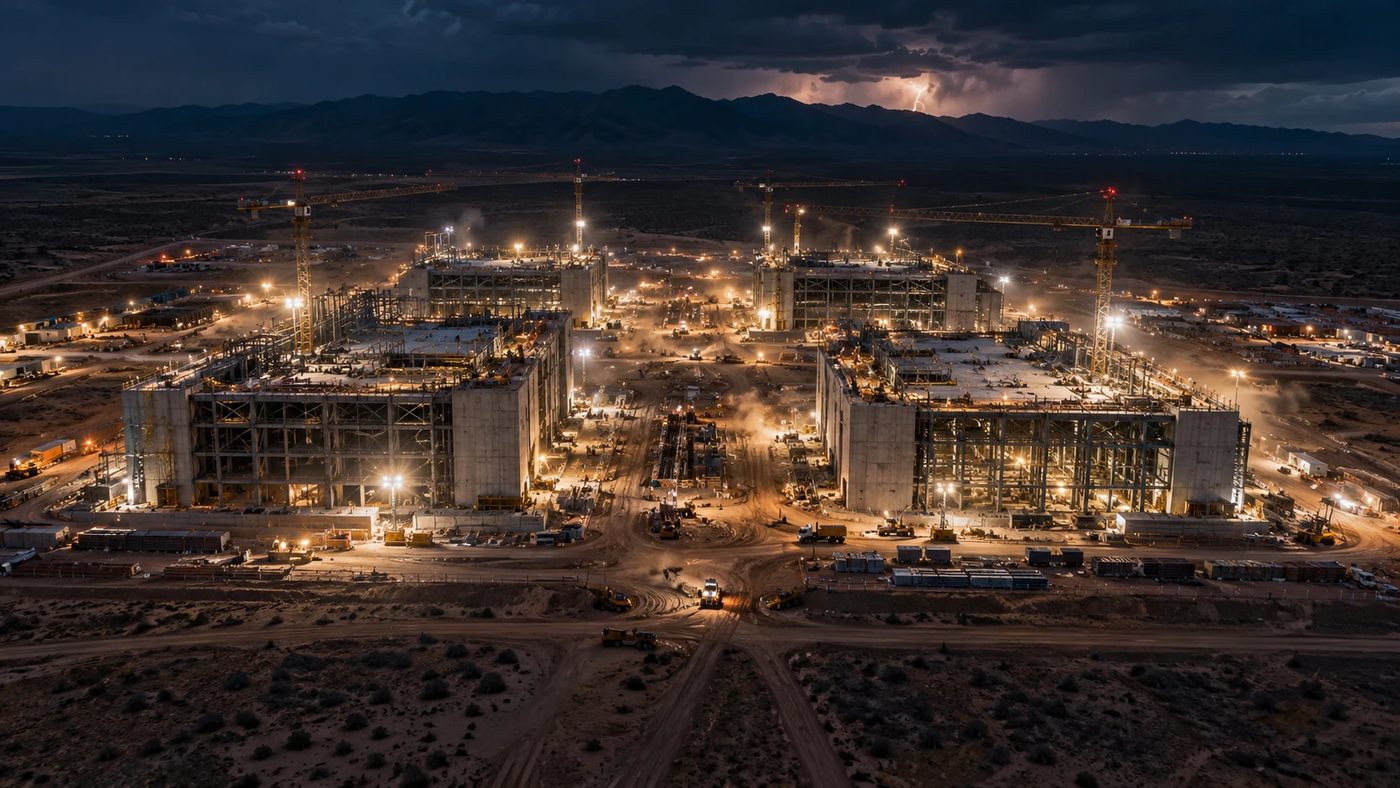

If you drive west out of El Paso and cross into New Mexico, you pass a construction site where about 3,500 workers are putting up four giant buildings on 1,400 acres of desert. When they are done, the buildings are supposed to pull 2.45 gigawatts of power. That is enough electricity, Bloomberg reported, to run roughly 1.8 million homes at once. The place is called Project Jupiter. It is one of the biggest pieces of Stargate, the artificial intelligence buildout President Trump announced at the White House with Larry Ellison, Sam Altman and Masayoshi Son.

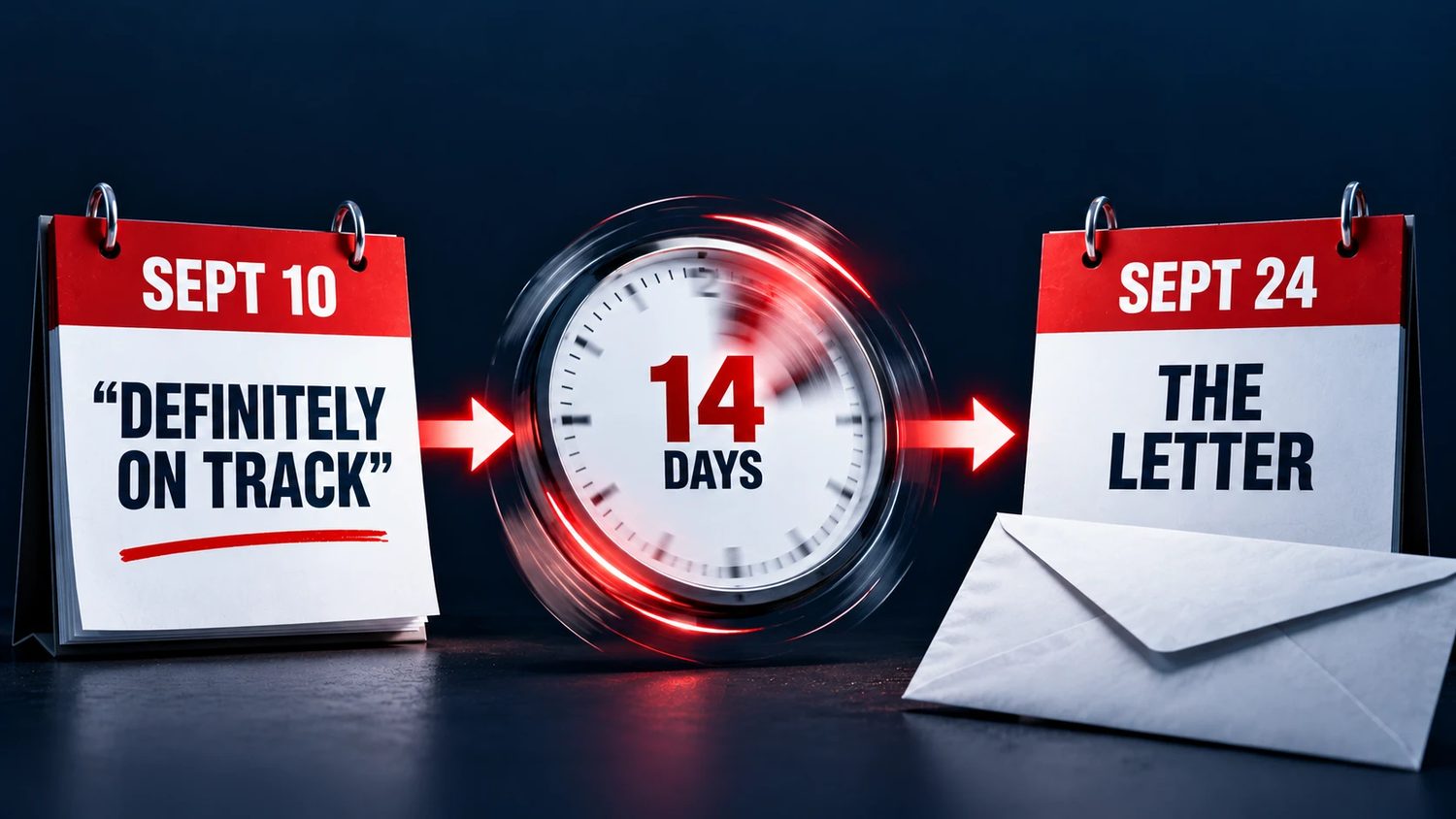

On September 24, Oracle, the company signed up to rent the whole campus, sent the builder a letter. It was a force majeure notice. That is a formal warning that something outside your control may stop you from keeping your side of a deal, so you may not have to pay on time.
Oracle says the letter means nothing. "Project Jupiter remains on our planned schedule," spokesman Michael Egbert said. The lenders who paid for the buildings were already acting like it means something. Six days before the letter, the Financial Times reported, banks were quoting the $18 billion construction loan at about 90 cents on the dollar.
The letter matters. It is the first time a company at the center of the AI boom has put in writing, to its own partners, that its biggest promise might not arrive on time. And the reason is not a chip shortage or a failed AI model. It is a 17-mile gas pipe that a state office would not let cross its land.
This is the prompt behind our own fact-checking tool. Paste it into any AI with web search on, add a claim or an article, and it returns two tables: every load-bearing claim with its full context and a verdict, then a second table of the actual sources with links. It grades what is factual, what is misleading, and what has no support — including on us.
What's in the rest of this article
- Who does what in the desert — Oracle, OpenAI, the builder and the banks, and who owes whom.
- The pipe the state said no to — why a power plant needs a gas line, and why New Mexico refused it twice.
- What the letter actually asks for — the three-year rent delay, and the catch Oracle does not mention.
- Oracle's money problem — the borrowing, the $288 billion in leases you will not find in the debt total, and what bond buyers are charging now.
- One customer, half the orders — how much of Oracle's future rides on OpenAI.
- Larry Ellison's shares — the pledged stock, the $7.5 billion sale plan, and the margin-call chain that could follow a falling price.
- The stack of promises — every layer, from the banks to OpenAI's investors.
- Oracle's case — the record quarter and what Oracle and its partners say back.
- What this means for you — your index fund, your retirement account and your state.
- What to watch next — the dates that will decide whether the buildings turn on.

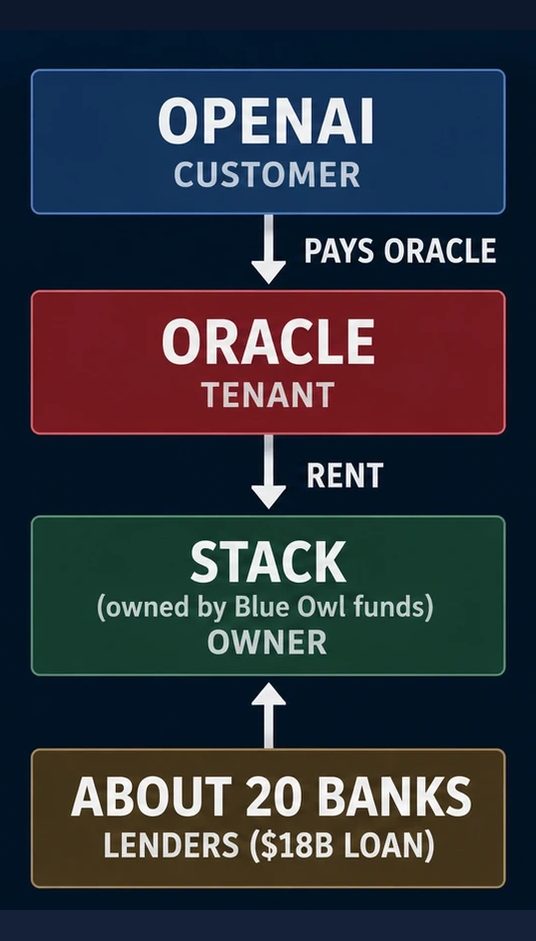

Who does what in the desert

Think of Project Jupiter like a giant apartment building that is being built for one tenant, and that tenant already has one customer lined up to fill every room.
The builder and owner is STACK Infrastructure, a data center company owned by funds managed by the investment firm Blue Owl Capital. A local developer, BorderPlex Digital Assets, is a partner. STACK owns the buildings, not Oracle.
Oracle is the tenant. It signs a long lease, fills the buildings with computer chips, and runs them. Then it rents that computing power to OpenAI, the company behind ChatGPT. Oracle sits in the middle. It owes rent to the builder on one side, and it waits for OpenAI's payments on the other. That is a fine place to stand as long as the building opens.

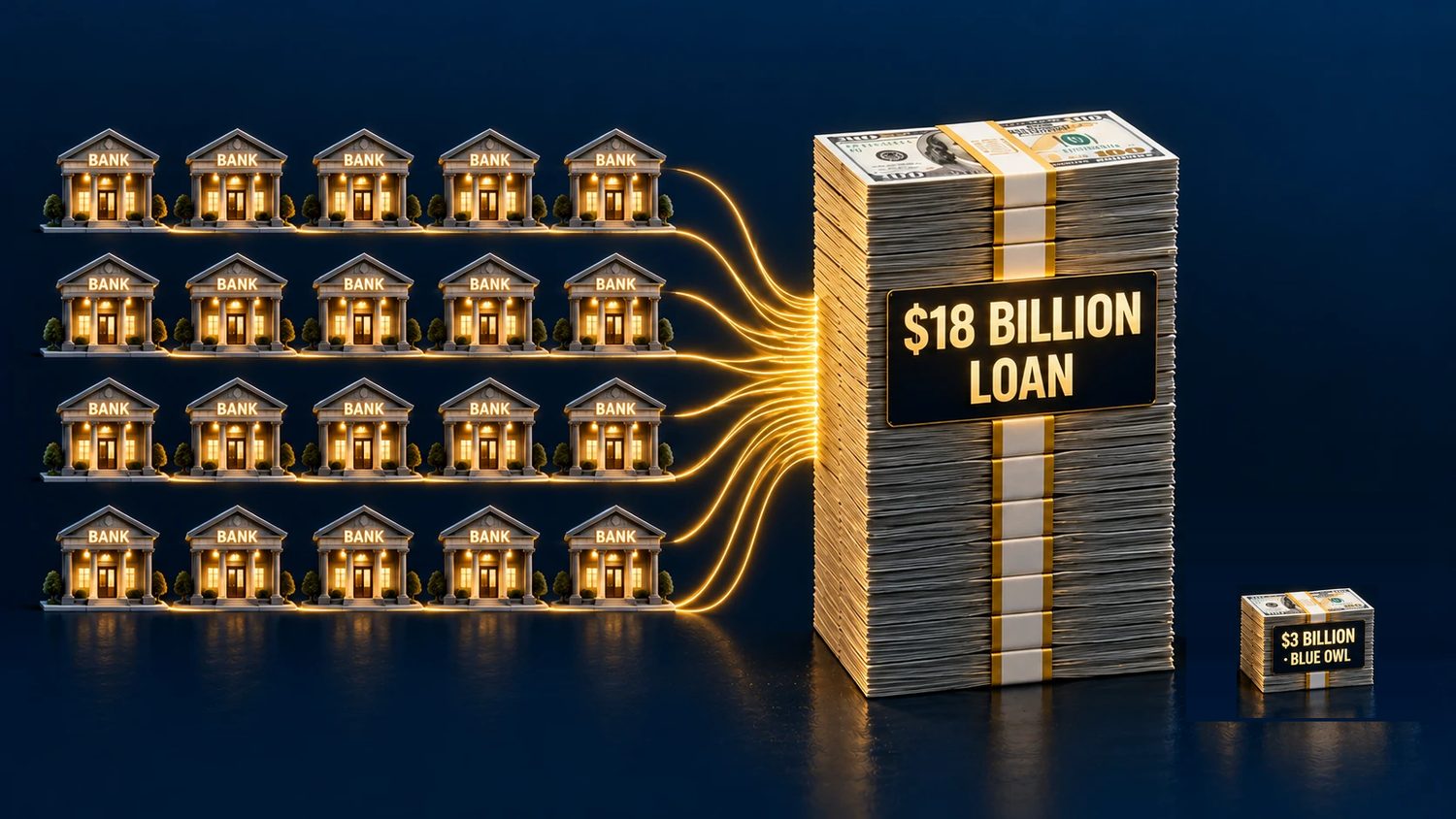

The money to build it came from about 20 banks, which lined up an $18 billion construction loan, according to Bloomberg and Reuters. Blue Owl put in about $3 billion of its own. Reuters reported that Blue Owl earns about 9% on that money while the buildings go up, and about 11% once they are finished.
Doña Ana County gave the project a big tax break to land it. In September 2025, county commissioners voted 4 to 1 to approve $165 billion in industrial revenue bonds, the amount the companies expect to invest. The deal takes the property off the regular tax rolls for up to 30 years. In exchange, the companies pay the county a flat $12 million a year, El Paso Matters reported. The same deal commits the developers to switch on a first phase between October and December 2026 and finish the whole campus by the third quarter of 2028.
Stargate itself was announced on January 21, 2025, as $500 billion of AI building over four years. Jupiter came later, as one of five U.S. sites in a $400 billion deal OpenAI signed with Oracle and SoftBank, according to Bloomberg.
The pipe the state said no to

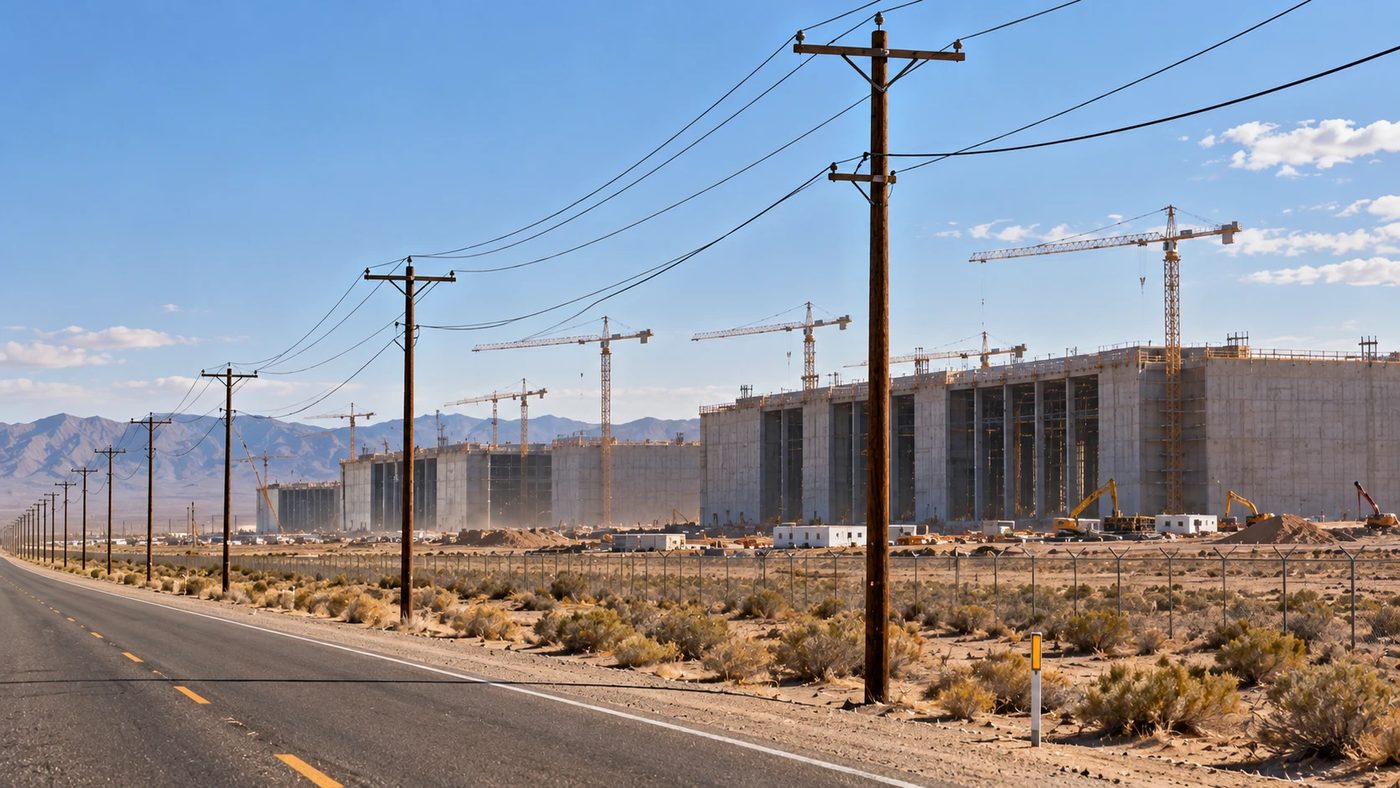

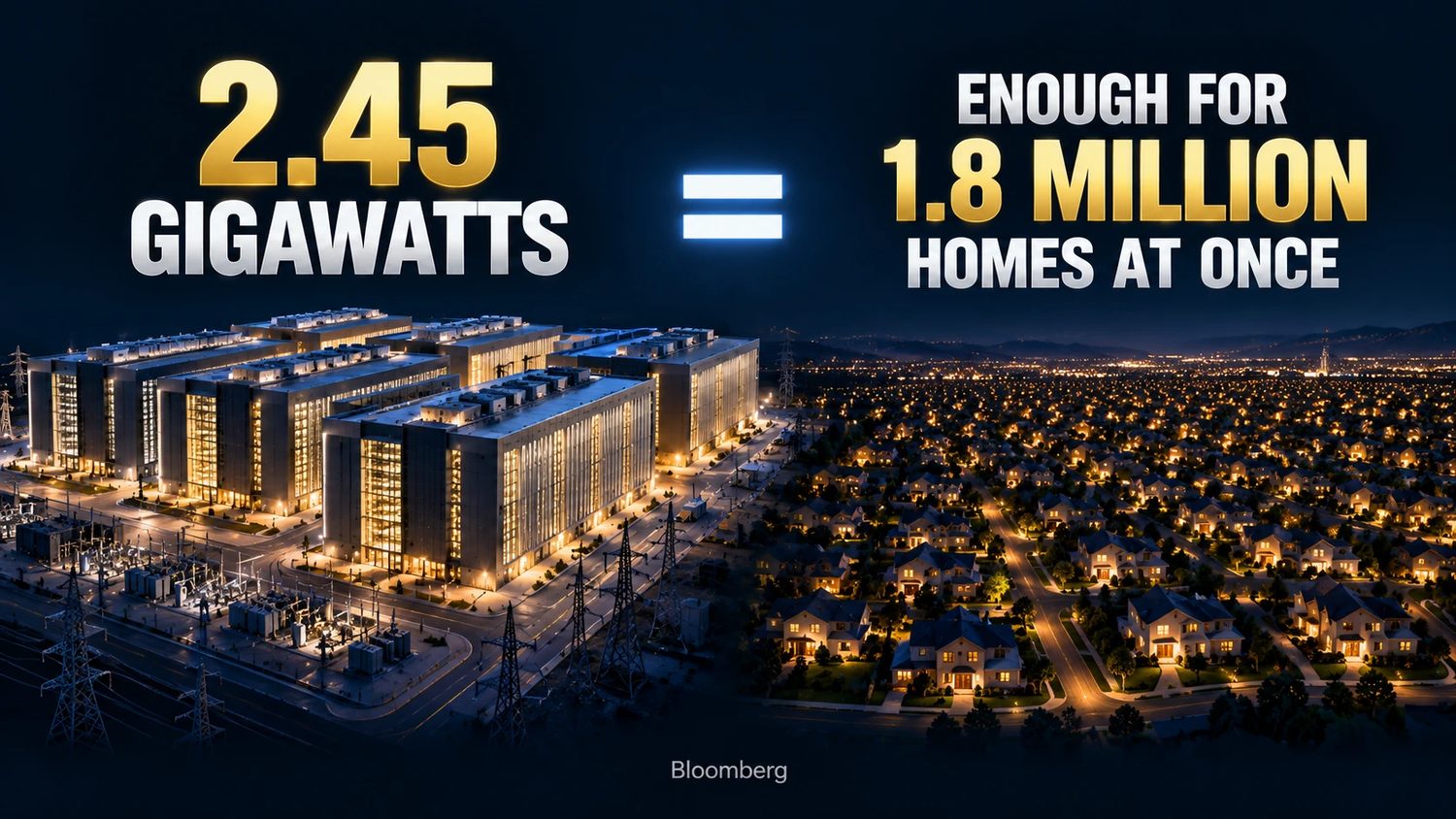

A campus that uses as much power as a mid-sized city cannot just plug into the local grid. The lines are not there. So the plan was always to make the power on site.
The first plan was gas turbines, like small jet engines that burn natural gas to spin generators. In April 2026, Oracle and BorderPlex switched to fuel cells from Bloom Energy. Fuel cells make electricity from gas through a chemical reaction instead of burning it. They cut the campus's expected greenhouse gas output from about 14 million tons a year to about 10 million, according to Searchlight New Mexico's timeline. That is about 28% less. It is still a huge amount, and the fuel cells still need gas.
The gas was supposed to arrive through a new 24-inch line called the Green Chile Lateral, about 17 miles long, built by an Energy Transfer company. Most of its route crosses private and federal land. About a mile of it, in two stretches, crosses state trust land, which is land New Mexico holds to raise money for its public schools. That short stretch needs a right-of-way permit from the New Mexico State Land Office.

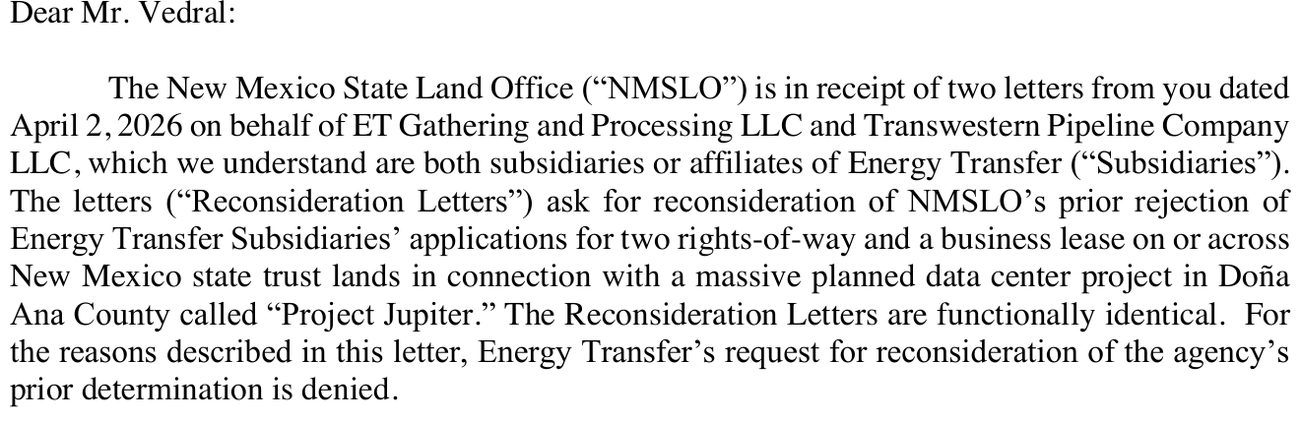

The State Land Office said no. On March 20, 2026, it told Energy Transfer's companies their applications were canceled. On July 14 it turned down a request to reconsider, in a letter posted on its website. The office said the school trust would earn almost nothing from it: a one-time payment of about $32,000 and about $43,000 a year. Land Commissioner Stephanie Garcia Richard told the trade outlet NGI that "advancing the massive use of gas for a project of this scale is simply not in the best interest of the trust."
The result: the pipeline's start date moved from about August 15, 2026, to February 1, 2027, in Energy Transfer's federal filing, Source NM reported. Some reports say the company is now trying to route around the state land. That has not been confirmed.
The pipe is not the only open permit. The air-quality permit for the fuel cells is still waiting at the New Mexico Environment Department, with a decision due by November 23. The state Supreme Court paused that case in August, then let it go forward again on September 17. The hearing officer stepped aside, and a new one, retired federal judge James Browning, was named in early October.
Then there is politics. Water and emissions have made the project a fight ahead of the November 3 election. Deb Haaland, the Democratic nominee for governor, has said she would sign an order pausing new large data centers if she wins, Source NM reported. She did not say whether that would reach Jupiter.
So one of the most important AI building projects in the country is waiting on a pipe, a permit and an election.
What the letter actually asks for

Force majeure is a clause in most big contracts. It covers events no one can control, like wars, floods and natural disasters. If one happens, the clause can excuse a company from deadlines or payments for a while.

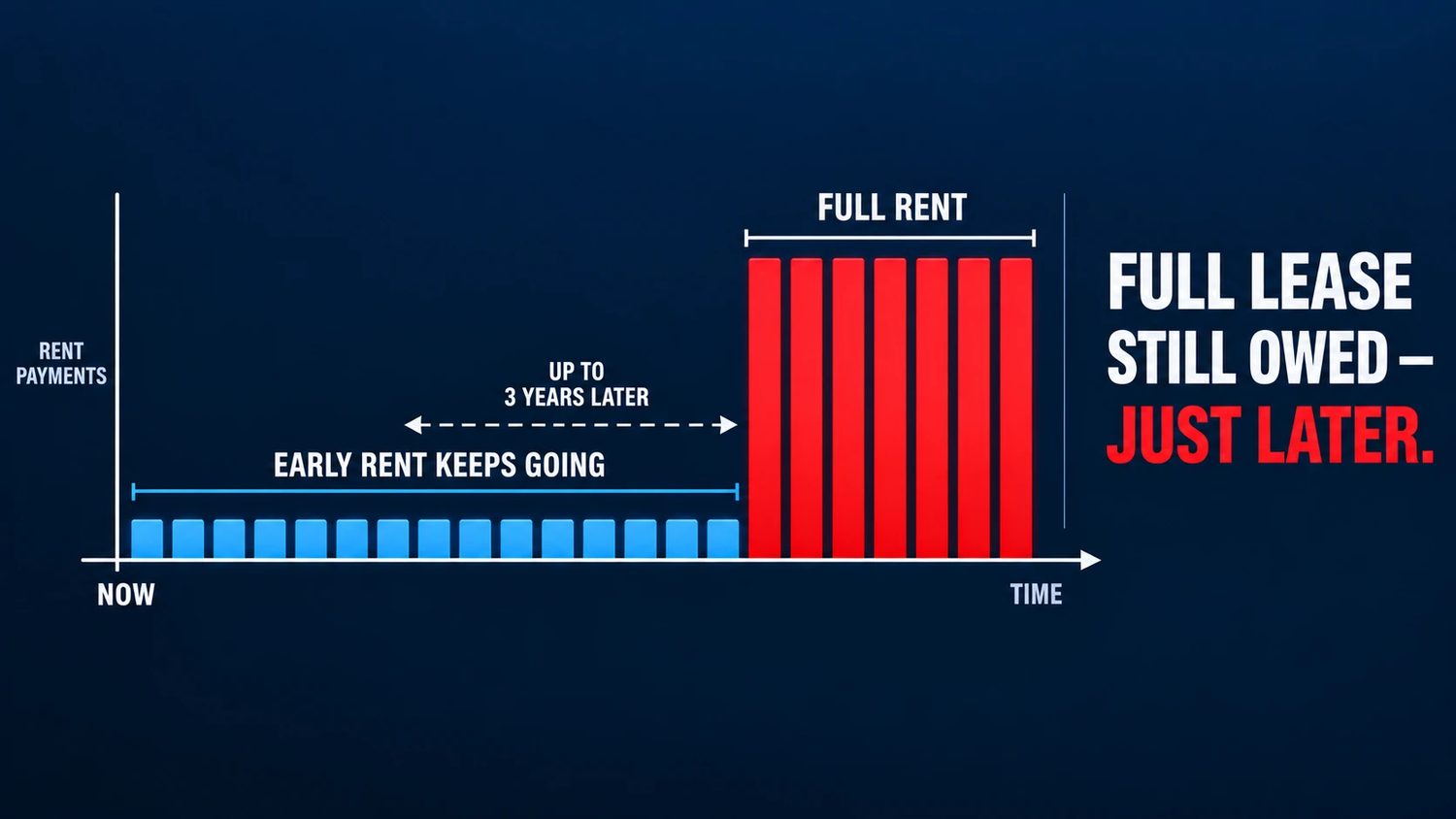

Oracle did not walk away. It did not cancel the lease. It is still the main tenant. What the letter does is reserve a right. If the two sides agree a force majeure event tied to power has happened, Oracle could win a delay of up to three years before its full rent starts, Bloomberg reported, citing a person familiar with the matter. Until then, Oracle would stay on a cheaper rent stage that comes before the full lease payments, Reuters reported. Bloomberg added that it is not certain the move would free Oracle, and that Oracle would still owe the full rent for the whole lease once payments begin.

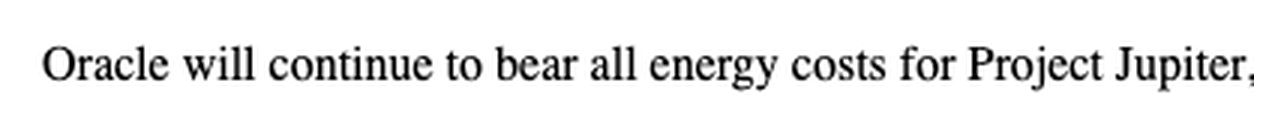

Oracle's official line is that the letter is routine. "Force-majeure notices are commonplace in developments of this scale," Egbert said. "They do not, by themselves, establish a project delay." Blue Owl said the notice "does not change the financial commitments to this multi-year project."
Here is the part Oracle does not lead with. Under its contract, Oracle carries full responsibility for securing power at the site, Reuters reported. Oracle's own April 2026 announcement said Oracle "will continue to bear all energy costs for Project Jupiter." So Oracle is claiming an act of God over the one thing the contract already made its job. Julien Simon, an AI industry writer, made that point in a piece he titled "An Act of God With Letterhead."
Think about your own lease. You do not send your landlord a letter about a flood you think will never come. A company sends one because it wants the right in its pocket before it needs it. Two weeks earlier, on September 10, Oracle co-CEO Clay Magouyrk told investors the data center was "definitely on track." Fourteen days later, the letter went out.
Oracle's money problem

If you have ever bought a house before you sold the old one, you know the squeeze. To fill buildings like Jupiter, Oracle has to buy the chips and sign the leases years before OpenAI's money shows up. It cannot pay for that out of its pocket.

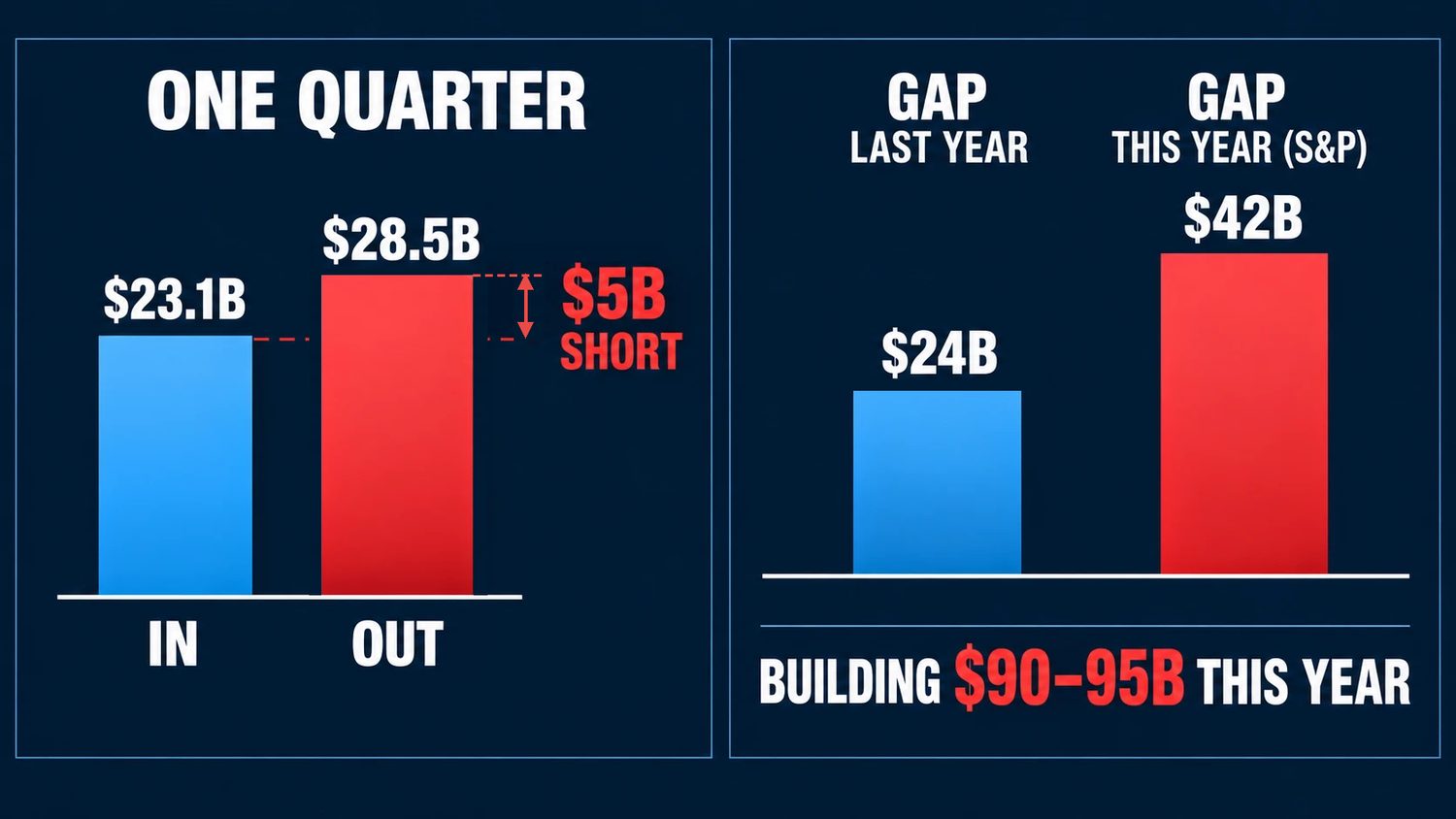

In the three months that ended August 31, Oracle took in $23.1 billion in cash from running its business and spent $28.5 billion building and buying equipment. That left it about $5 billion short in a single quarter. For its last full fiscal year, the gap was about $24 billion. S&P, one of the big credit rating companies, expects a gap of about $42 billion this year as Oracle spends $90 billion to $95 billion on building.
Oracle fills the gap with other people's money. It sold $19.9 billion of new stock this year, starting one day after Larry Ellison set up a plan to sell his own shares, Filing Insights found. Nothing shows the two moves were linked. If you own Oracle stock, every new share it sells makes your slice a little smaller. And it borrows. At the end of August, Oracle owed about $125 billion in notes and loans, its quarterly filing shows. Count the leases already on its books and the total is about $169 billion.

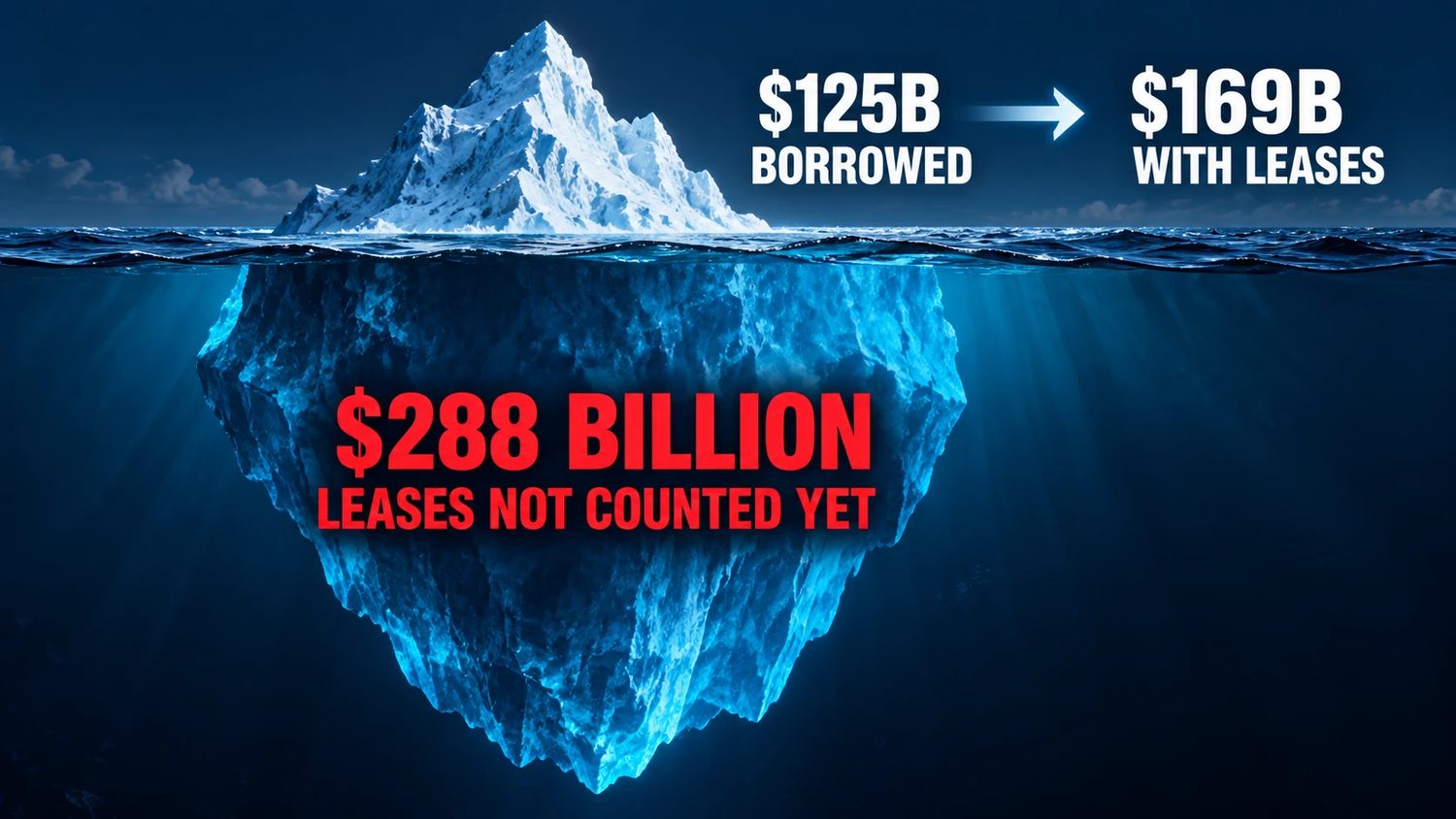

The bigger number sits in a footnote. Oracle has signed another $288 billion of leases, "substantially all related to data center arrangements," that have not started yet, its August quarterly report says. Accounting rules leave a lease off the balance sheet until it begins. These leases start between now and 2029 and run 15 to 19 years. That is more than double everything Oracle has borrowed. The number everyone quotes is the small one.

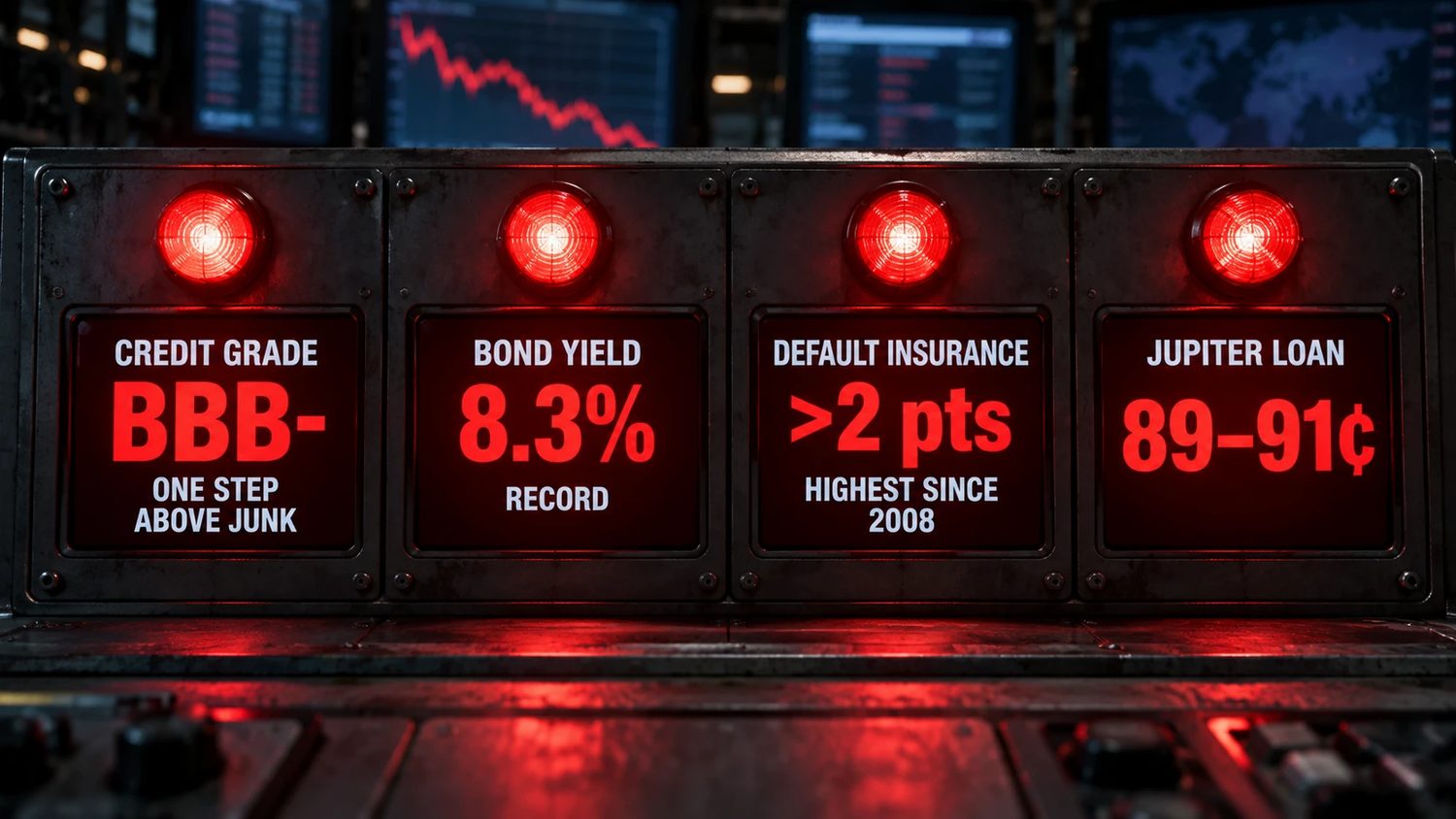

Bond buyers have noticed. In July, S&P cut Oracle's credit rating to BBB-minus, one step above junk. Junk is the label for bonds with a real risk of not being paid back. Moody's, another rating company, has Oracle on a negative outlook. Some of Oracle's long-term bonds hit a record yield of about 8.3% around September 24, according to market data relayed from Bloomberg. A yield is the interest rate a buyer demands to hold the bond, so a higher one means lenders want more pay for more risk.
The price of insurance against Oracle missing its debt payments, called a credit default swap, went above 2 percentage points a year in September. That is a level last reached during the 2008 financial crisis, Fortune reported.
The Jupiter loan tells the same story. On September 18, the Financial Times reported that banks including Santander and Jefferies were quoting the $18 billion in loans at 89 to 91 cents on the dollar. The banks had planned to sell pieces of the loan to other investors and could not, so they were left holding more of it. If you held a piece of that loan, you could only sell it for about 90 cents of every dollar you were owed. A loan that trades at 90 cents means the market thinks there is a real chance it will not be paid back in full. That was six days before the letter. The letter did not start the worry. It confirmed it.
The letter is not a default. Bloomberg reported that it "does not constitute an event of default" on the loan, and the loan is still being paid. A 90-cent quote is a price, not a loss. But prices are where trouble shows up first.
One customer, half the orders

In September 2025, Oracle and OpenAI signed a cloud deal reported at $300 billion over five years, starting in 2027, according to the Wall Street Journal. That one contract changed Oracle's order book overnight.

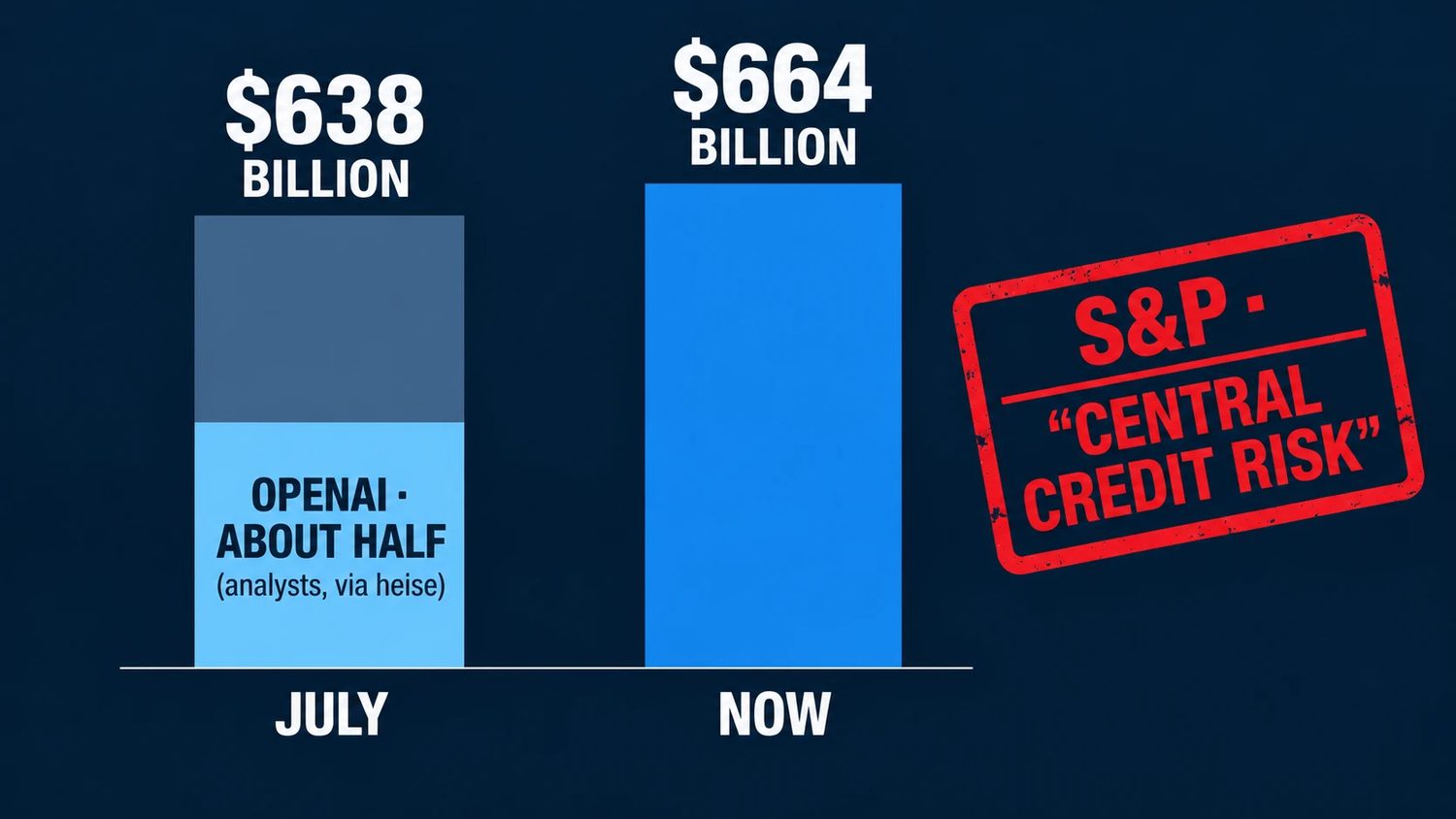

Oracle now says it has $664 billion of business signed and not yet delivered. When S&P cut Oracle's rating in July, the backlog was $638 billion, and analysts estimated about half of it was owed by OpenAI, heise reported. S&P called OpenAI a "central credit risk" for Oracle. Our AI bubble article walks through that part of the chain.
If you are counting on Oracle's backlog, you are mostly counting on OpenAI. A large share of Oracle's future is one company's promise to pay. And OpenAI pays largely with money it raises. In 2025 it also announced huge deals and agreements with Nvidia, AMD, Broadcom and CoreWeave. To cover them, it depends on new funding rounds, SoftBank's backing, its deal with Microsoft, and maybe a stock market listing someday.
Put the two together. Oracle borrows money to build for a customer that pays its bills with money raised from investors. Each side's numbers look good as long as the other side keeps going.
Larry Ellison's shares

Larry Ellison co-founded Oracle and is its chairman. He owns about 38% of the company, about 1.16 billion shares, according to the proxy statement Oracle filed in late September.

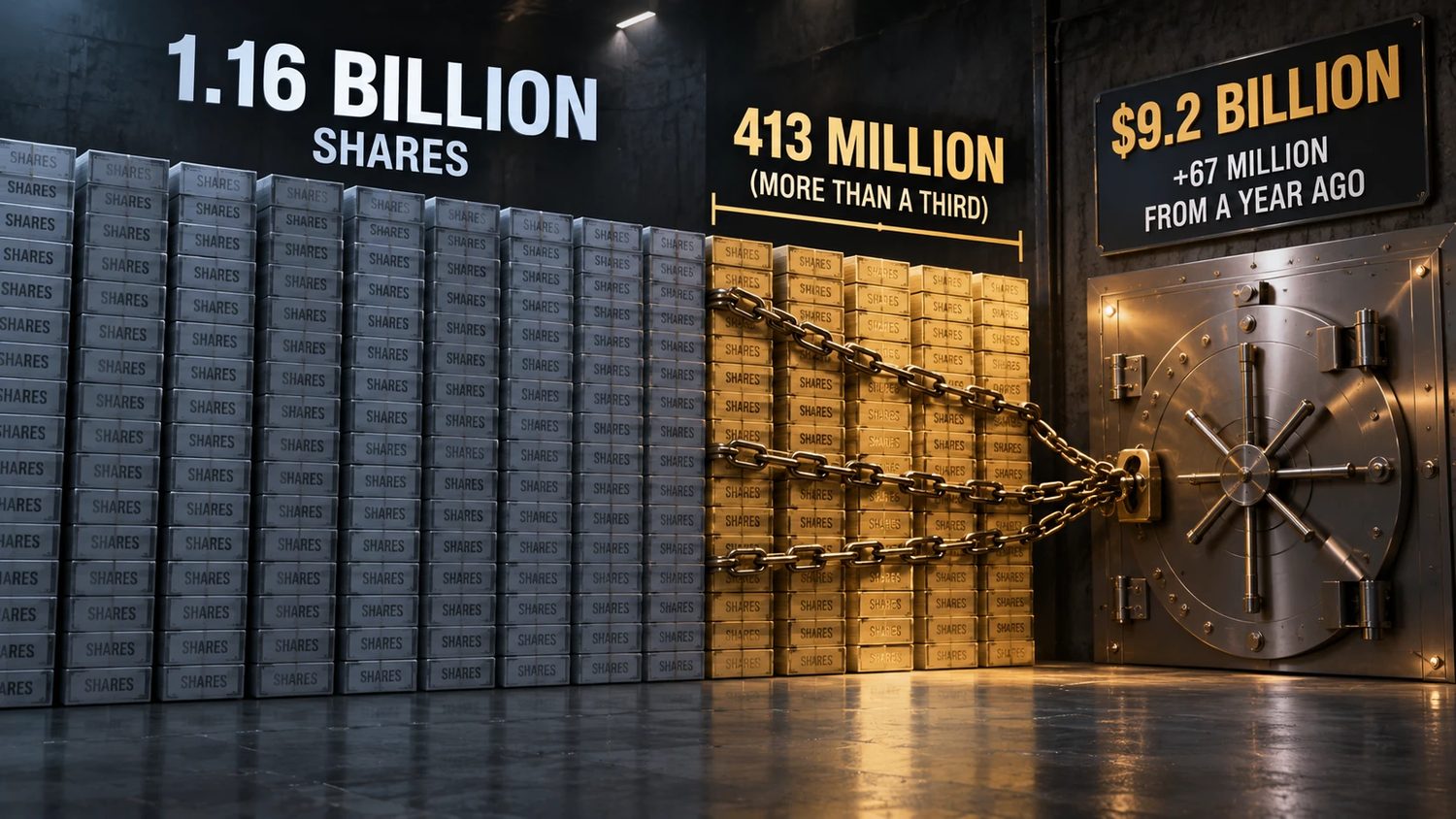

He has pledged 413 million of those shares as collateral for personal loans. That is more than a third of his stake. It is 67 million more shares than a year earlier, worth about $9.2 billion at the September 25 closing price. The board says the loans fund his "outside personal business ventures." CNBC has reported that Ellison helped finance the Skydance and Paramount merger, run by his son David Ellison, and is backing a bid for Warner Bros. Discovery.

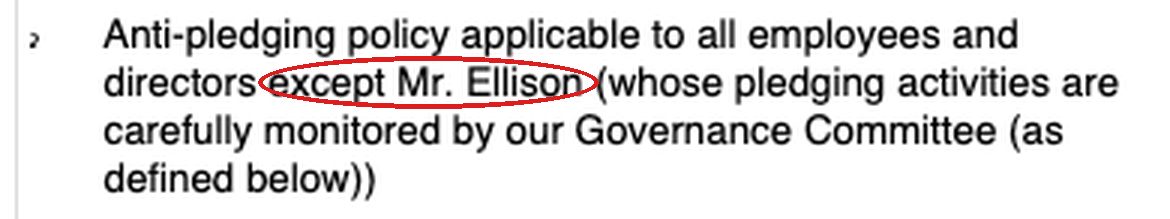

Oracle has a rule against this. Its policy bans employees and directors from pledging company stock as collateral, with one exception: Larry Ellison. The proxy summary says it in so many words: "Anti-pledging policy applicable to all employees and directors except Mr. Ellison."
Why should you care about one man's loans? A loan backed by stock is sized by what the stock is worth. If the price falls far enough, the shares no longer cover the loan. Then the lender can ask for more cash or more shares. That is called a margin call. If the borrower cannot meet it, the lender can sell the pledged shares.

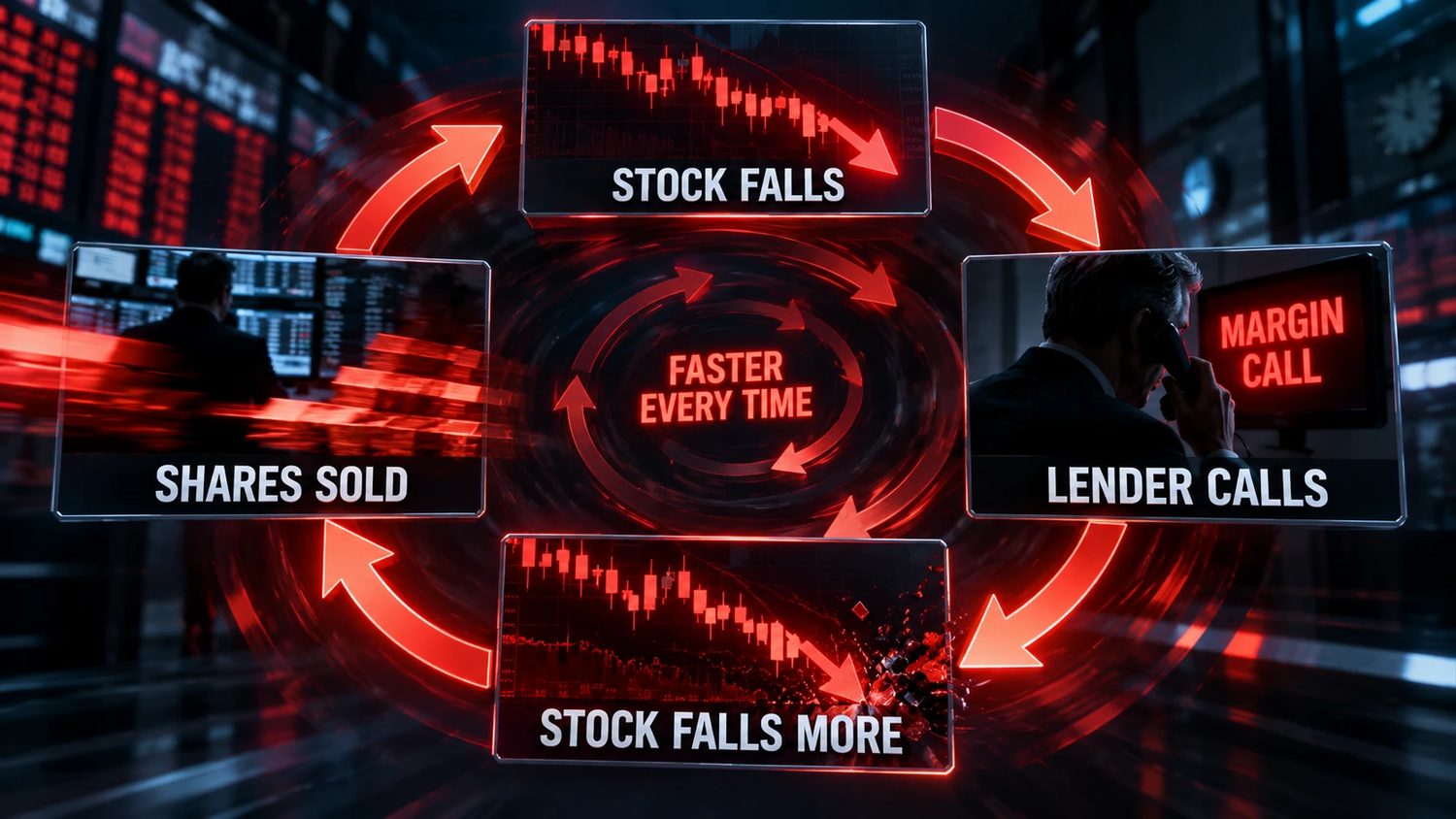

The chain could run like this. Oracle's stock falls. A lender asks Ellison for more collateral. If he cannot or will not meet it, hundreds of millions of shares could hit the market. Selling that many pushes the price down further. That weakens the collateral that is left, which can bring the next call. Oracle's stock was about $145 in early October, about 55% below its high of $322.54 last fall, so this is not a far-off picture.
The board's answer: none of the shares sit in a margin account, and it "believes that Mr. Ellison has the financial capacity to repay his personal term loans without resorting to the pledged shares." He is one of the richest people on earth, so that may be true. It is still a bet on one man's other businesses holding up, sitting under the stock of a company that is borrowing record amounts.
Then there was the sale plan. On June 22, Ellison set up a plan to sell up to 50 million Oracle shares, worth about $7.5 billion, before October 24. These pre-set plans, called 10b5-1 plans, let executives schedule sales ahead of time. CNBC noted that, by FactSet's records, Ellison had not sold more than 25,000 shares at once this century.
Shareholders found out on Friday evening, September 11, when the plan showed up in Oracle's quarterly filing. The next day, a Saturday, Oracle announced Ellison had canceled it. "No Oracle stock was sold under the plan," the company said, and he "has no other plans to sell." By then the stock was more than 18% below where it closed the last trading day before he set up the plan, Reuters reported. Reuters tied that drop to Oracle's spending and cash worries, not to the plan.
No shares were sold. But a plan is a signal. The man who knows Oracle best, the man asking investors to back one of the most aggressive AI buildouts in American business, quietly put himself in position to sell $7.5 billion of it. Twelve days after the cancellation, the force majeure letter went out.

The stack of promises

From the bottom up:
- The banks get paid if the builder collects rent.
- The builder collects rent if Oracle pays.
- Oracle pays if OpenAI pays for the computing power.
- OpenAI pays if its investors keep writing checks.
- And Oracle's full rent does not start until the campus switches on.
If you pull out any one layer, the ones under it feel it. Each layer leans on the layer above it, like a stack of chairs where every chair is resting on the one on top. It holds as long as nobody moves. Today, the whole stack is resting on something much plainer than chips or AI models. It is resting on a gas pipe in the desert that is now due February 1, and a permit due by November 23.
Nothing here says Ellison did anything illegal. The point is how much of this rests on a few people's choices. Billions in debt, buildings and stock value can move on what one man decides to do with his shares.

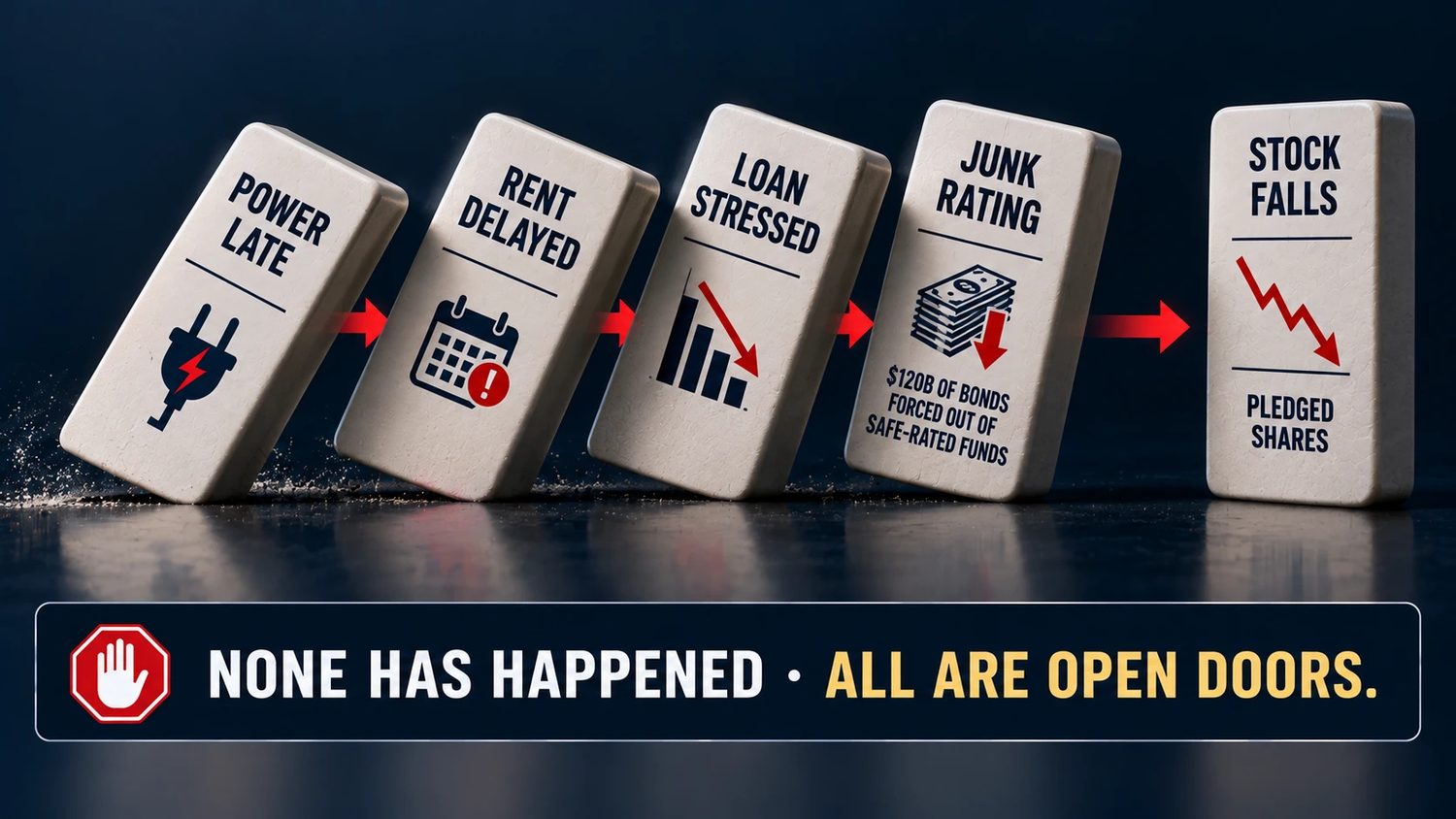

Most earlier warnings about the AI buildout came from short sellers, analysts and commentators, people outside the deals. This one came from inside. A company in the middle of the chain told its partners, in writing, that one piece might not arrive on time.
That is how this could unravel, step by step. It is a chain of possibilities, not a forecast. If the power is late, Oracle's rent delay could kick in. If rent is delayed, the builder's payout is delayed and the loan stays stressed. If Oracle's costs keep running ahead of its cash, the rating agencies could cut it to junk. A downgrade to junk would push about $120 billion of Oracle bonds out of the investment-grade indexes that many funds follow, according to market reports, which would force those funds to sell. Forced selling makes borrowing more expensive for Oracle, right when it needs to borrow most. And a falling stock brings the pledged-share chain back into play.
None of those steps has happened. Every one of them is a real door that is now open.
Oracle's case

Oracle has real numbers on its side, and you should weigh them.

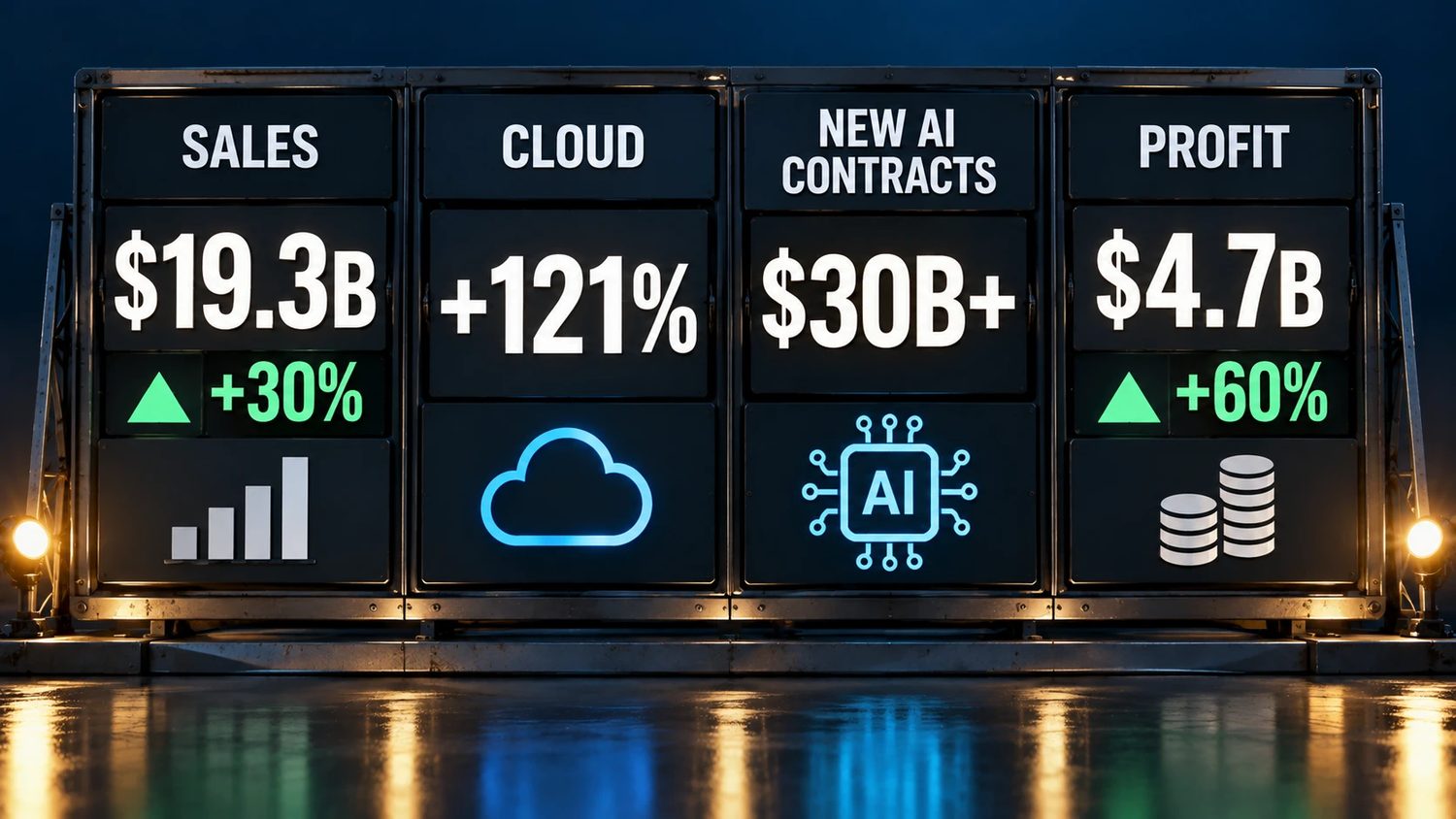

Two weeks before the letter, Oracle reported its quarter. Revenue was $19.3 billion, up 30%. Its cloud infrastructure business grew 121%. It signed more than $30 billion of new AI contracts, raised its forecast, and said it delivered 850 megawatts of new capacity. Customer demand, Oracle said, "continues to grow faster than supply." Net income was $4.7 billion, up 60%.
Magouyrk argued on the call that a plan needing "100% achievement of every one of their deliverables" is "a bad plan," which is why a company builds in slack. Blue Owl said the partners are "fully aligned." Bloom said on X that it remains committed and on schedule. After a flood reached the site on September 30, Oracle and STACK said "no critical infrastructure was damaged."
Some analysts agree with Oracle. William Blair kept its buy rating and saw little effect on this year's revenue, Reuters reported. A Motley Fool writer argued on September 30 that Oracle's 8% bond yields are "an Oracle problem, not an AI problem," because Microsoft, Alphabet, Amazon and Meta can pay for their buildings out of their own cash. Even Filing Insights, which is skeptical, called Jupiter a case of "supply struggling to come online on schedule, not demand collapsing."
That is a fair point. You and millions of other people want what Oracle is building. But it also makes the case. If demand is real and Oracle still has to lean this hard on borrowed money, lenders, and one customer, then the risk is not whether AI is useful. The risk is whether the money holds out until the buildings turn on.
What this means for you

You may not own Oracle stock on purpose. You probably own it anyway. Oracle is in the S&P 500, so S&P 500 index funds hold it, and many target-date retirement funds hold it through their stock funds. Its bonds sit in many bond funds that buy investment-grade debt. If Oracle were cut to junk, the funds that must sell would include the kind in a lot of 401(k) plans.
Banks and private credit firms, the lenders outside the regular banking system, are carrying the Jupiter loan. If projects like this stumble, those losses travel. They show up in the funds and pensions that bought into private credit for higher returns.
If you live in New Mexico, this is on your ballot. The tax break, the water, the air permit and a possible pause on new data centers are all live questions in the November 3 election. The deal pays about $12 million a year, most of it to the county and some to schools, and that payment depends on the project going forward.
And if you just use AI tools, the cost of building them is not only paid in dollars. Much of it is paid with borrowed money that has to be paid back, by companies like Oracle whose stock is in your savings.
What to watch next

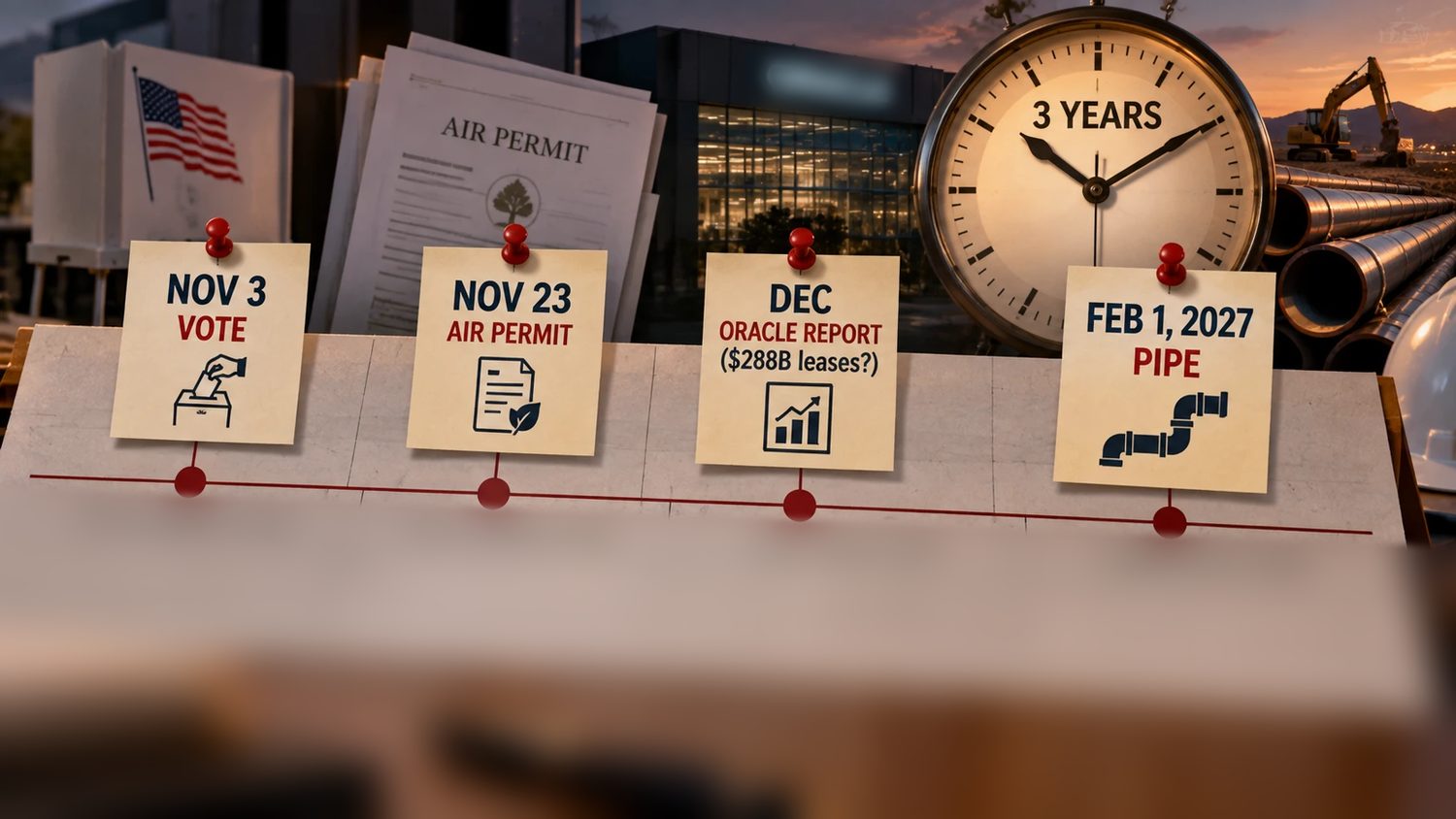

Mark these dates if you want to know how this ends.
- November 3: New Mexico's governor election. A pause on new large data centers is on the table.
- November 23: Deadline for the state's decision on the fuel cell air permit.
- Early December: Deadline for other agencies' decisions on the pipeline's federal permits, according to Julien Simon's reading of the filings.
- Around December: Oracle's next quarterly report is expected. Watch the cash gap, the borrowing, and whether the $288 billion of unstarted leases grows.
- Oracle's next filings: any new sale plan or change in Ellison's pledged shares will show up there.
- February 1, 2027: The pipeline's new start date. If that slips, the three-year clock in Oracle's letter starts to matter.
Oracle may be right that the letter is just paperwork. But paperwork is how companies get ready for what they think could happen. And for now, one of the biggest AI projects in the country is waiting on a pipe.
Sources
- Bloomberg, via Insurance Journal: Oracle force majeure notice on Project Jupiter (Sept 25, 2026)
- CNBC: Oracle data center force majeure (Sept 24, 2026)
- Reuters, via BNN Bloomberg: Oracle triggers force majeure over power delays (Sept 24, 2026)
- Reuters, via Global Banking & Finance: Oracle cites force majeure
- El Paso Matters: Project Jupiter rent and force majeure (Sept 24, 2026)
- Yahoo Finance: Why Oracle's force majeure notice is freaking out AI bulls
- Searchlight New Mexico: Timeline: the evolution of Project Jupiter (Sept 18, 2026)
- New Mexico State Land Office: Letter denying reconsideration (July 14, 2026)
- NGI: New Mexico rejects Energy Transfer bid to revive Green Chile lateral
- Source NM, via Organ Mountain News: Green Chile pipeline delayed to 2027 (Aug 18, 2026)
- Albuquerque Journal: NM Supreme Court and the Project Jupiter permit (Sept 1, 2026)
- The Bond Buyer: Bonds approved by New Mexico county for data center (Sept 22, 2025)
- Oracle 10-Q for the quarter ended Aug 31, 2026: SEC filing
- Oracle Q1 fiscal 2027 results: SEC exhibit (Sept 10, 2026)
- Oracle 2026 proxy statement: SEC filing
- Oracle 8-K on Ellison's canceled plan: SEC filing
- CNBC: Larry Ellison's 50 million share trading plan (Sept 11, 2026) and Ellison nixes the plan (Sept 12, 2026)
- Reuters, via The Edge Malaysia: Oracle shares and Ellison's plan
- Filing Insights: Two SEC filings, twelve days
- heise: S&P downgrades Oracle to BBB- (July 13, 2026)
- Fortune: S&P kept Oracle investment grade (Sept 18, 2026)
- Motley Fool: Oracle's 8% bond yields (Sept 30, 2026)
- FT reporting on the loan, via Ground News: Oracle's $18 billion data center debt under pressure (Sept 18, 2026)
- The Decoder, citing the Wall Street Journal: OpenAI signs $300 billion cloud contract with Oracle (Sept 11, 2025)
- Julien Simon: An Act of God With Letterhead
- American Bazaar: Oracle says Project Jupiter undamaged after flooding (Oct 1, 2026)
- Source video: Finance Bureau, Oracle JUST Started the AI COLLAPSE
